Are you a DNP student looking for a powerful tool to help you manage and visualize your project timeline? The DNP project Gantt chart is an invaluable resource specifically designed for nursing students like you, who are tackling complex projects as part of their doctoral journey. With the DNP Project Gantt Chart, you can easily create, track, and adjust your project schedule with ease. In this article, we will guide you through the benefits and features of this essential tool, empowering you to conquer your DNP Project with confidence and efficiency.
Introduction to DNP Project Gantt Chart for Nursing Students
The DNP Project Gantt Chart template is a helpful tool that can be used to organize and outline the various phases of the project. This bar chart provides a visual representation of the timeline for each task, allowing students to monitor their progress and make any necessary improvements along the way.
By using a Gantt chart, nursing students can implement their projects more effectively, ensuring that all tasks are completed in a timely manner. This project timeline chart also allows students to estimate the appropriate amount of time needed for each task, preventing any delays in the project completion.
In addition, the DNP Project Gantt Chart helps students maintain privacy and citation by keeping all project information in one organized document. This tool is essential for the successful completion of DNP projects and can be a valuable resource for nursing students throughout their academic careers.
Main Elements of DNP Project Gantt Chart
A DNP project Gantt chart typically includes several key elements that are essential for effective project management:
1. Task List: This is a comprehensive list of all the tasks required to complete the project. Each task should be clearly defined and broken down into manageable components.
2. Timeline: The timeline is the backbone of the Gantt chart, showing the duration of the project from start to finish. It is usually displayed along the top of the chart and is divided into days, weeks, or months, depending on the project’s length.
3. Bars: Each task is represented by a bar on the Gantt chart. The length and position of the bar indicate the start date, end date, and duration of the task.
4. Milestones: Milestones are significant events or checkpoints in the project. They are typically represented by diamond-shaped symbols and are crucial for tracking progress and ensuring that key objectives are met on time.
5. Dependencies: Dependencies show the relationships between tasks. They indicate which tasks must be completed before others can begin, helping to identify the critical path and manage task sequencing effectively.
6. Resource Allocation: This element assigns team members or resources to specific tasks, ensuring that all necessary resources are accounted for and properly utilized.
How to Use Gantt Chart for DNP Project
1. Define Your Project Scope and Objectives
Before creating your Gantt chart, it is essential to clearly define the project’s scope and objectives. This includes identifying the project’s goals, deliverables, and overall purpose. Having a well-defined scope helps ensure that all necessary tasks are included and that the project stays focused and aligned with its objectives.
2. Identify Key Milestones
Milestones are critical checkpoints that signify the completion of significant phases or tasks within the project. Identifying key milestones early on helps structure the project and provides clear targets for measuring progress. Examples of milestones in a DNP project might include the completion of the literature review, approval of the project proposal, data collection, and final project submission.
3. Determine Task Dependencies and Durations
Understanding the relationships between tasks is crucial for effective project management. Determine which tasks depend on the completion of others and map out these dependencies on your Gantt chart. Additionally, estimate the duration of each task, considering factors such as complexity, resource availability, and potential obstacles.
4. Assign Resources and Set Deadlines
Allocate the necessary resources to each task, including team members, equipment, and materials. Clearly define who is responsible for each task and set realistic deadlines based on your task duration estimates. Ensure that resources are distributed efficiently and that no team member is overburdened.
5. Track Progress and Make Adjustments
Regularly update your Gantt chart to reflect the actual progress of the project. Compare planned timelines with actual performance to identify any discrepancies or delays. Use this information to make necessary adjustments, such as reallocating resources, extending deadlines, or modifying task sequences. Keeping the Gantt chart up-to-date helps ensure that the project remains on track and that any issues are promptly addressed.
Project Management Plan and Gantt Chart
When embarking on a new project, it is essential to have a well-thought-out proposal outlining the aim and objectives of the project. In developing a project management plan, it is crucial to consider the ethical implications of the project, especially when dealing with sensitive data such as electronic health records. Before any tasks have been completed, it is important to determine who will be responsible for completing each task and what type of data will be collected.
The first step in creating a Gantt Chart is to obtain all the necessary information about the project and the tasks must be completed. Each task and milestone should be listed on the left side of the page and a timeline should be created at the top or bottom of the page, with days or weeks indicated. To construct the Gantt Chart, each task must be sequenced in the order it needs to be completed, drawing a diamond to represent each milestone achieved within a period of time.
Once all the tasks are listed and the timeline is set up, it is important to place a vertical marker on the timeline to indicate the current date. This helps the team stay on track and see what tasks are left to be completed. The Gantt Chart should also be shaded to show when each task is expected to start and finish. This visual representation is crucial for trying to achieve project deadlines and ensuring all team members are on the same page.
Before collecting any data, it is important to consider the institutional review board (IRB) requirements, especially when dealing with quantitative or qualitative data collection. All team members should be aware of the ethical implications of their research and how to obtain the necessary approvals. By utilizing tools such as Excel or project management software, project managers can ensure that the project stays on track and is completed successfully.
Gantt Chart Example

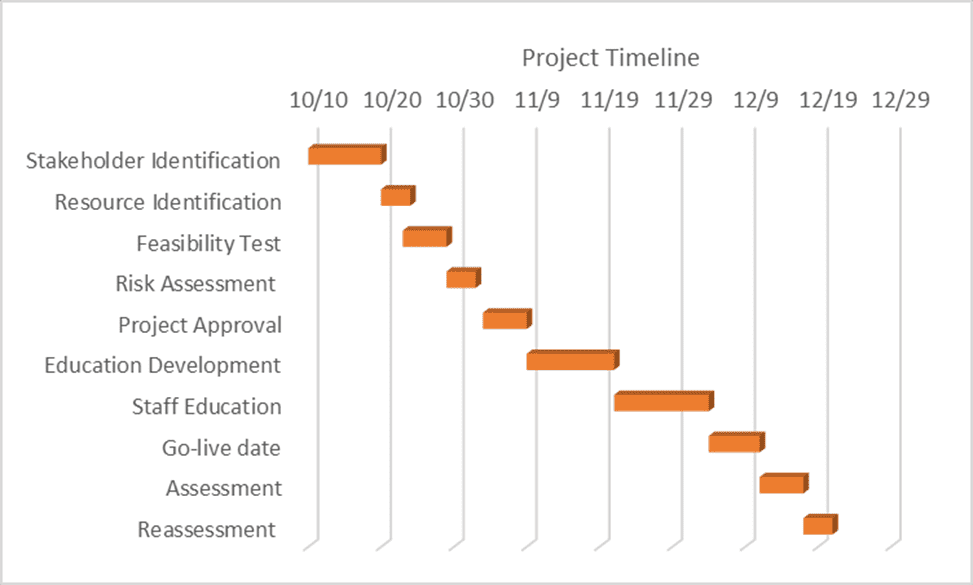

Below is an example of a Gantt chart for a DNP project:
Project Name | Project Duration | Project Start Date | Project End Date | ||
Addressing IPV | 10-Oct-24 | 21-Dec-24 | |||
Task ID | Task Description | Stakeholder Responsible | Task Duration (Days) | Start Date | End Date |
1 | Stakeholder Identification | Project Manager | 10 | 10-Oct-24 | 19-Oct-24 |
2 | Resource Identification | Project Manager | 4 | 20-Oct-24 | 23-Oct-24 |
3 | Feasibility Test | Project Team | 6 | 23-Oct-24 | 28-Oct-24 |
4 | Risk Assessment | Project Team | 4 | 29-Oct-24 | 2-Nov-24 |
5 | Project Approval | Project Sponsor and Functional Managers | 6 | 3-Nov-24 | 8-Nov-24 |
6 | Education Development | Project Team | 12 | 9-Nov-24 | 20-Nov-24 |
7 | Staff Education | Educators and Mentors | 13 | 21-Nov-24 | 3-Dec-24 |
8 | Go-live date | Project Team | 7 | 4-Dec-24 | 10-Dec-24 |
9 | Assessment | Project Team | 6 | 11-Dec-24 | 16-Dec-24 |
10 | Reassessment | Project Team | 4 | 17-Dec-24 | 21-Dec-24 |
This Gantt chart outlines the main tasks, their durations and stakeholders responsible, providing a clear roadmap for the project.
Conclusion
The Gantt Chart serves as a visual representation of the timeline for each task and milestone in the project. It ensures that tasks are completed within the appropriate time frame and helps keep the project on track. DNP students can use the Gantt Chart to monitor their progress and make adjustments as needed to ensure a successful outcome. However, you can seek our writing services for expert guidance and support if you need DNP project assistance with creating a Gantt Chart or any other aspect of your project.
FAQs
- How do I create a Gantt chart for a project timeline? To create a Gantt chart for a project timeline, use project management software or tools like Microsoft Project, Excel, or online platforms such as Smartsheet or Trello, where you can input tasks, durations, and dependencies to visualize the project schedule.
- What is a Gantt chart in nursing? In nursing, a Gantt chart is used to plan, schedule, and track nursing activities, patient care tasks, and staff assignments, ensuring efficient workflow and time management within a healthcare setting.
- How do you format a Gantt chart in a project? To format a Gantt chart in a project, include task names, start and end dates, durations, and dependencies, then use bars to visually represent these elements along a timeline, ensuring clarity and ease of understanding for stakeholders.
- How do you represent a project timeline? A project timeline is represented by listing key tasks and milestones in chronological order, often using visual tools like Gantt charts, timelines, or milestone charts to display the sequence and duration of activities.
